construction.live Article
Your Tower Crane Is Down: How an AI Scheduler Tests Recovery Options
See how an AI scheduler can test crane-outage recovery options, protect a construction milestone and turn schedule optimization into a clear field decision.
Imagine it is Friday afternoon. The crane vendor has informed you that the tower crane must be taken out of service for five working periods. Your current schedule coordinates structural work, foundations, MEP releases, material staging and dry-in. The next project meeting is Monday morning. What are you going to tell all the trades?
What work is affected? What can continue? How far does the milestone move if the team waits? Would temporary lifting capacity protect the date?
Do you need to be a master scheduler to figure out your options? This is where AI agents can really help you. An AI scheduler can test construction scheduling scenarios, check resource limits and turn the results into a plan the project team can review. This guide shows how that workflow can complement a construction schedule app, P6 or Microsoft Project.
1. Turn the field event into a planning problem
The starting point is information the project already has: the current schedule, activity logic, durations, available crews and equipment, the outage dates and the dry-in target.
You need to provide this information to the AI agent. You can upload an Excel file, PDF or another schedule format.

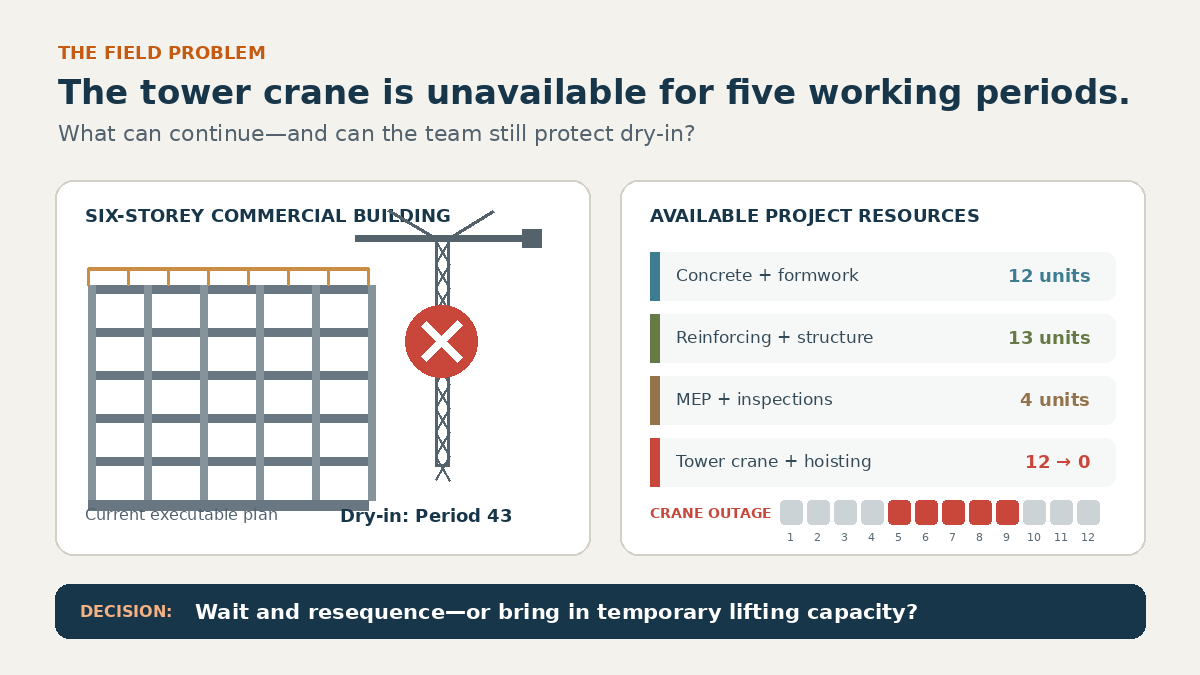

Problem setup: The current executable plan targets dry-in at Period 43. During the outage, available tower-crane capacity drops from 12 planning units to zero.
2. AI agents can run scheduling scenarios, so ask for decisions
To do your analysis, you do not need fancy software like P6 or an advanced scheduling system. Many optimization programs are available online for free.
So why have we been paying for P6 and Microsoft Project? Good question. These programs were built for specialized users, so they can be difficult to run if you are an average user. They require technical knowledge, and activities must be entered in a very specific way, which can create more work than the solution itself.
But the good news is that an AI agent can use these programs without you having to worry about the technical details. It can transform activities into the format the scheduling engine requires. Best of all, you do not need to tell the agent every technical step. Just do not be too vague about the decision you need.
“Optimize my schedule” is too vague. A useful request names the changed condition, the alternatives and the rules that cannot be broken.
Review the uploaded schedule. The tower crane will be unavailable during Working Periods 36 through 40. Compare waiting for the repair with temporary lifting capacity. Preserve all predecessors, durations and resource limits. Identify the minimum substitute capacity required to retain the Period 43 dry-in milestone. Return the changed activities, resource loading, completion date and a constraint check.
This request produces several useful optimization questions:

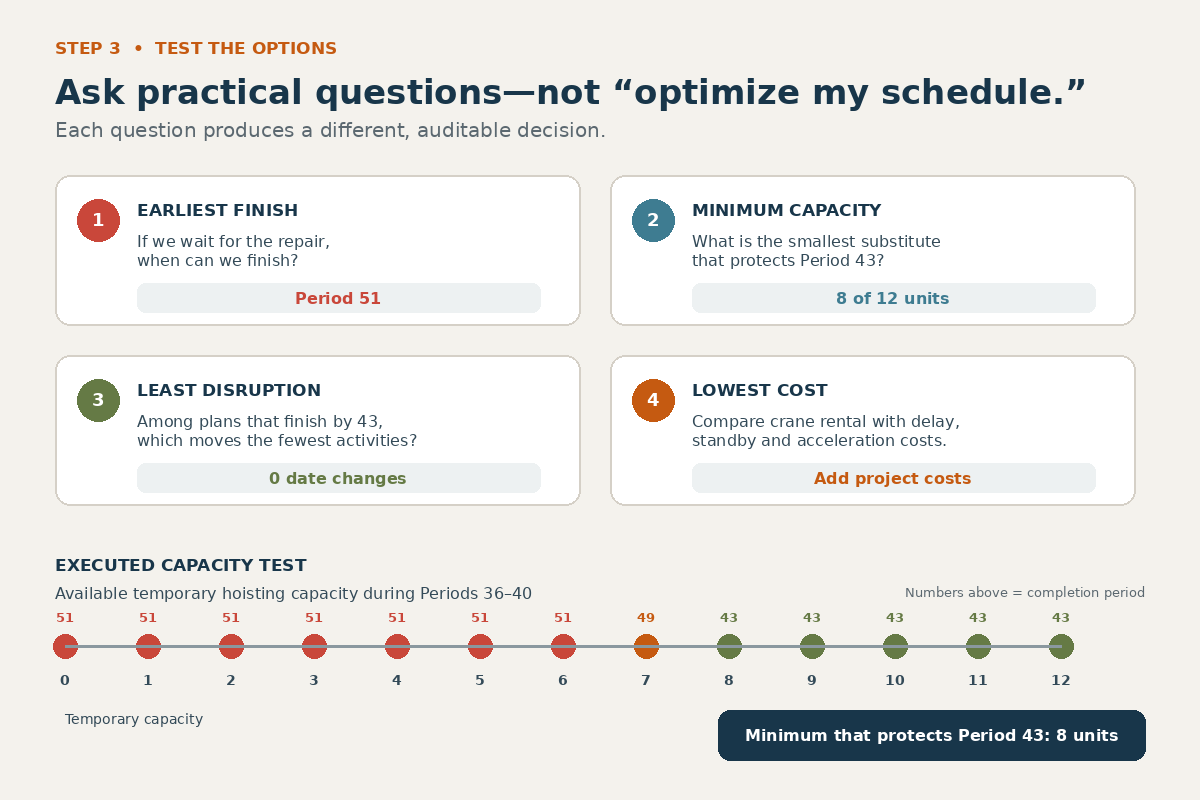

- Earliest finish: If the project waits, what is the earliest feasible completion?
- Minimum capacity: What is the smallest temporary lifting resource that protects Period 43?
- Least disruption: Among the plans that protect the date, which one changes the fewest activities?
- Lowest total cost: Is temporary lifting capacity less expensive than delay, standby and acceleration?
Executed test: Completion remains at Period 51 with zero to six temporary units, improves to Period 49 with seven units, and returns to Period 43 with eight units.
3. Test possible arrangements against the rules
The agent will run the program and come up with a solution. Do not accept the first solution the AI produces; iterate and test alternative theories. Critique the agent’s work.

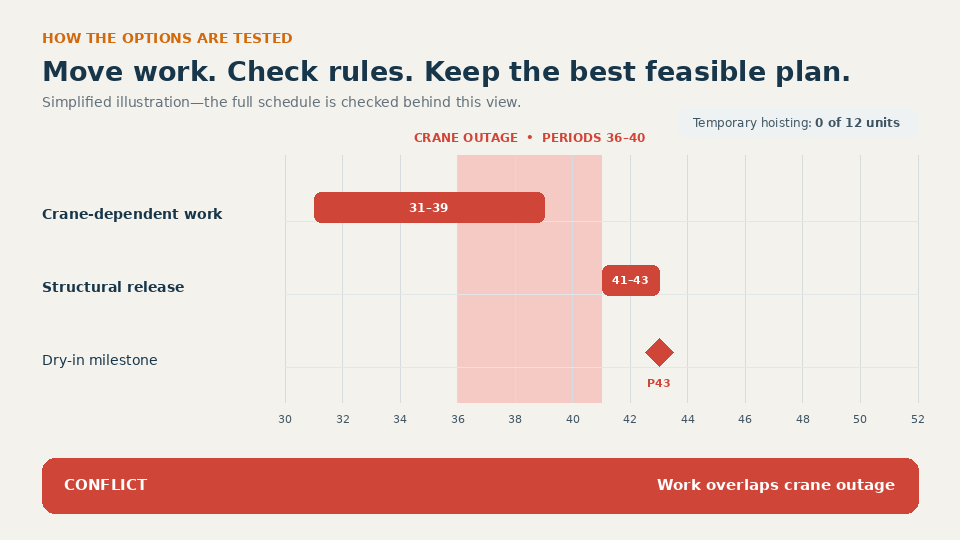

- Identify the conflict. The current crane-dependent operation overlaps the Period 36–40 outage.
- Move work outside the outage. Waiting creates a feasible sequence, but it pushes the dry-in milestone to Period 51.
- Try alternative arrangements. Candidates are rejected if they overload a crew or crane, violate a predecessor, change a duration or miss the required milestone.
- Test temporary capacity. The available substitute capacity is increased until the system finds a feasible Period 43 plan.
- Minimize disruption. Among milestone-compliant plans, the system looks for the option that changes the fewest current dates.
Simplified optimization walkthrough: The animation shows the decision logic. The complete calculation checks all activities, predecessors and resource limits behind this focused view.
4. Compare the verified results

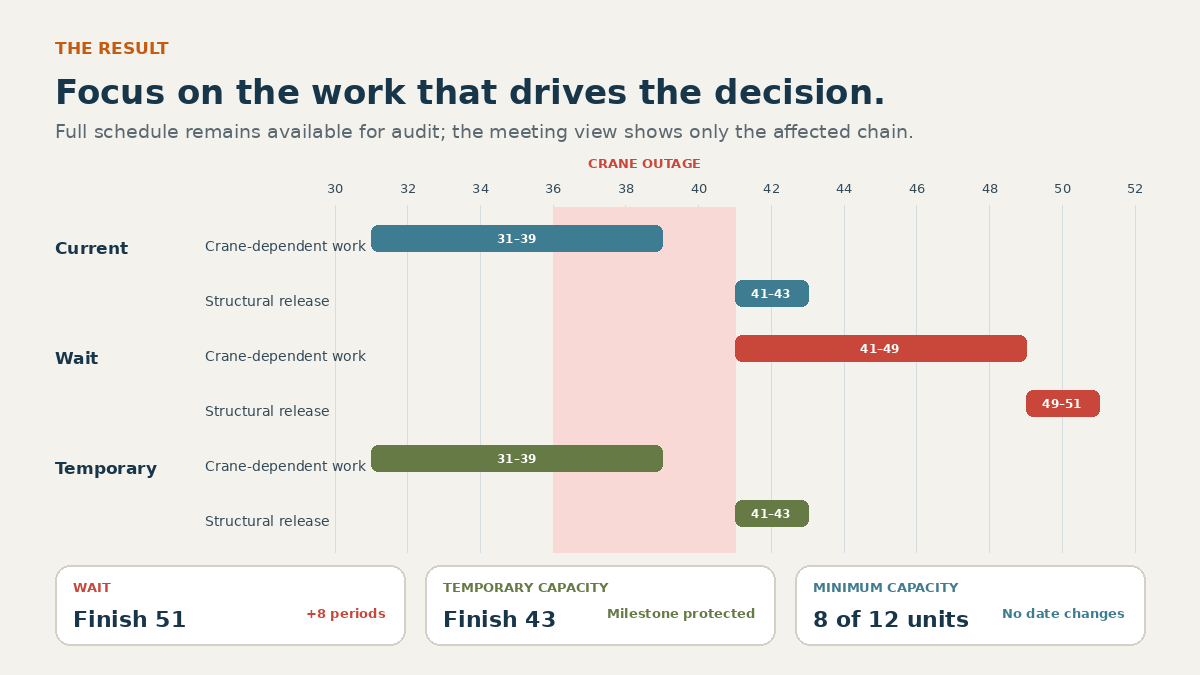

- Wait and resequence: Completion moves to Period 51, an eight-period delay.
- Limited substitute capacity: Seven units improve completion to Period 49 but do not eliminate the delay.
- Minimum milestone-protecting option: Eight of 12 hoisting units retain Period 43.
- Least disruption: The model protects the milestone without changing the current activity dates.
In the problem we selected, eight of the normal twelve hoisting-capacity units are sufficient to retain the current sequence and Period 43 completion. The scenario was checked against activity durations, predecessor logic and period-by-period resource limits.
5. Finally, ask the agent to make the results presentable
A thirty-row Gantt is useful for audit, but it is not the clearest first view for the project manager. The meeting graphic should focus on the work driving the decision, with the full schedule available if someone wants to inspect it. This is as easy as asking the AI agent to produce a Gantt chart.
Decision Gantt: Waiting moves the affected operation and structural release. Eight units of temporary capacity retain the Period 43 milestone without moving the current dates.
6. Take a recommendation, not raw analysis, into the meeting
The five-period crane outage creates an eight-period schedule delay if we wait for the repair. We tested different levels of temporary lifting capacity. Seven units reduce the delay but do not eliminate it. Eight of the normal twelve units protect the Period 43 milestone without changing the current activity dates. We should now confirm the temporary crane’s lift feasibility and compare its total cost with eight periods of delay, trade standby and extended general conditions.
What still requires the project team
Schedule feasibility is not lift approval. The result gives the team a quantified option to investigate; it does not select or approve a crane.
Confirm before acting
- Actual loads, radii, pick dates and required hoisting windows
- Temporary-crane capacity, configuration and load-chart compliance
- Access, setup area, ground-bearing pressure, outriggers and mats
- Engineering, inspections, permits, traffic control and lift planning
- Rental, mobilization, standby, delay and acceleration costs
- Trade-partner agreement with the proposed sequence
The practical takeaway
The value of AI construction scheduling is not a complicated chart or a claim that software knows the job better than the superintendent. It is the ability to test more viable options quickly, consistently and under the same project rules.
In plain language: Move the activities that can move, preserve the sequence that cannot change, stay within available crews and equipment, reject plans that break the rules, and keep the best verified option for the project team to review.
This is an illustrative scheduling demonstration. Field conditions, commercial terms, engineering and safety requirements must be independently verified.
Written by
Rahul Vaishnav
