RFI in Construction: A Complete Guide to Requests for Information

Published 5/11/2026Updated 5/11/2026Written by Rahul Vaishnav

Master construction RFI management with this complete guide covering the RFI process, templates, best practices, cost reduction strategies, and AI-powered workflow solutions that help contractors prevent delays and protect margins.

RFI in Construction: A Complete Guide to Requests for Information

If you've spent any time managing a construction project, you know that waiting on an RFI response can feel like watching concrete dry, except the concrete keeps costing you money the whole time. Research shows that a single RFI costs a construction firm an average of $1,080 to process, and the collective burden across a project can exceed $850,000. On a $5 million project, RFI-related costs alone can run close to $100,000.

That's not a paperwork problem. That's a project risk problem.

This guide breaks down everything contractors, project managers, estimators, and preconstruction teams need to know about construction RFI management, what it is, how it works, where most teams get it wrong, and how AI-powered workflow platforms are redefining how the best firms handle it.


What Is an RFI in Construction?

A Request for Information (RFI) is a formal document used on construction projects to clarify missing, incomplete, or conflicting information in drawings, specifications, contracts, bid packages, or scope documents.

When a contractor, estimator, or subcontractor encounters something unclear, such as a missing dimension, a spec conflict, or a coordination gap between disciplines, they submit an RFI to the responsible design or engineering party to get an official answer before proceeding.

RFIs are not optional administrative paperwork. In most contracts, they are a contractual obligation. When errors, conflicts, or omissions are discovered in project documents, most agreements require formal notification, and the RFI is the primary tool used to fulfill that requirement.

Who Submits RFIs?

  • General contractors

  • Subcontractors

  • Estimators

  • Procurement managers

  • Project engineers

  • Site foremen

Who Receives and Responds?

  • Architects

  • Structural, civil, and MEP engineers

  • Design consultants

  • Project owners

  • Construction managers

Common Reasons RFIs Are Issued

  • Missing or unclear dimensions

  • Conflicting specifications between drawings and specs

  • Material substitution requests

  • Design discrepancies between disciplines (architectural vs. structural vs. MEP)

  • Site conditions not reflected in contract documents

  • Procurement clarifications

  • Regulatory compliance questions

  • Schedule and sequencing conflicts

The core purpose of an RFI is simple: prevent teams from making assumptions that turn into expensive field problems.


The Construction RFI Process: Step-by-Step

The RFI process follows a reasonably linear path, though depending on the complexity of the issue and the stakeholders involved, certain steps may require iteration before resolution is reached.

Step 1: Issue Identification

A contractor, estimator, or field team member identifies unclear or conflicting information that requires a formal answer before work can proceed.

Step 2: RFI Creation

The request is formally documented, including the specific question, relevant drawing or specification references, supporting attachments, and a requested response deadline.

Step 3: Submission

The RFI is submitted to the appropriate party, typically routed through the project manager or construction manager before reaching the architect, engineer, or owner.

Step 4: Review

The receiving party reviews the RFI for completeness and relevance. If the request is unclear, they may ask for additional context before preparing a response.

Step 5: Response

The architect, engineer, or consultant researches the issue and prepares an official written response.

Step 6: Approval and Distribution

The response is reviewed and approved by the appropriate team member, then distributed to all stakeholders who need the information, including field teams and subcontractors.

Step 7: Implementation and Closure

If the RFI response requires design revisions, procurement changes, or schedule adjustments, those updates are implemented and documented. The RFI is then formally closed in the project log.

Important: RFIs are not submittals, change orders, or contracts. They are requests for clarification. Do not use them as a substitute for routine communication, verbal discussions, or safety documentation.

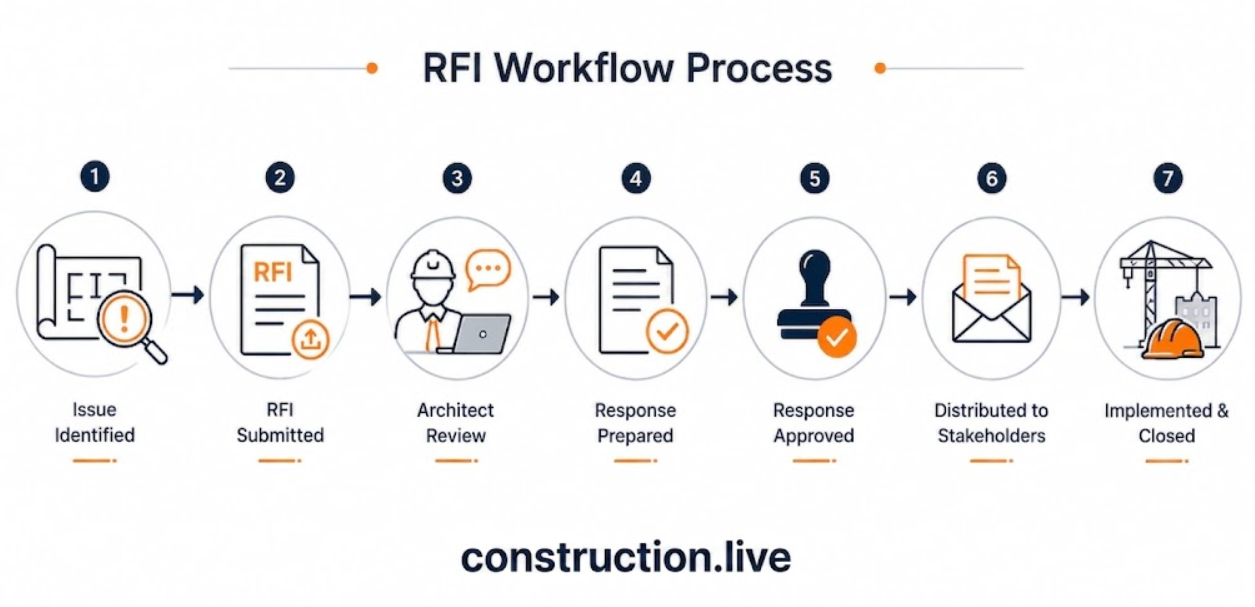

A 7-step construction RFI workflow process diagram: Issue Identified, RFI Submitted, Architect Review, Response Prepared, Response Approved, Distributed to Stakeholders, and Implemented & Closed.


What to Include in a Well-Structured RFI

An RFI without the right components creates more confusion than it resolves. A well-structured RFI should include:

  • Unique RFI number (sequential, project-specific)

  • Submission date

  • Project name and number

  • Originating party and recipient

  • Clear subject line

  • Specific, answerable question (one issue per RFI where possible)

  • Drawing and specification references

  • Supporting attachments (photos, sketches, redlined drawings)

  • Suggested solution (when you have one, this accelerates response time)

  • Required response date

  • Response field (for the receiving party)

  • Status tracking (open, pending, closed)

Why Structure Matters

Standardized RFIs reduce communication friction, speed up responses, and create a searchable audit trail. Without consistency, RFI logs become unmanageable, especially on complex, multi-discipline projects where dozens or hundreds of RFIs may be active simultaneously.

RFI Best Practices at the Document Level

Ask one question per RFI. Bundling multiple issues into one request slows the response and creates tracking confusion. If the issues are related, note that relationship, but keep questions separate.

Add context that anyone can understand. Don't write an RFI that assumes the recipient was standing next to you when you discovered the problem. Include the exact nature of the issue, which parties are impacted, where on the project it occurs, and why a timely response matters.

Suggest a solution when possible. This reframes the RFI as an action item rather than an open question. It also demonstrates professional expertise and often results in faster turnaround.

Attach photo documentation. A clear photo of the conflicting condition eliminates ambiguity faster than any written description. Field teams should default to attaching photos whenever possible.


RFI vs. RFQ vs. RFP vs. Change Order

Understanding how RFIs relate to other construction documents prevents misuse and keeps your documentation strategy clean.

An RFI clarifies incomplete or conflicting project information.

An RFQ (Request for Quotation) requests pricing from suppliers or subcontractors on defined scope.

An RFP (Request for Proposal) requests broader technical or service solutions from vendors.

A Change Order formally documents and approves a change to scope, budget, or schedule.

The key relationship to understand: RFIs often precede change orders. When an RFI reveals a design conflict or scope gap, the resolution may require a formal change order. Teams that manage RFIs poorly often see disproportionately high change order volumes because the underlying issues weren't caught and resolved early enough.


Types of RFIs and Who's Involved

Different RFI categories involve different stakeholders and follow slightly different resolution paths. Understanding these distinctions helps you route requests correctly from the start.

1. Design Clarification RFIs

Originated by: General contractor or subcontractor
Resolved by: Architect or design consultant

These are the most common type, arising when drawings are incomplete, specifications conflict, or design intent is unclear. They typically route from the site engineer through the project manager to the architect.

2. Material Specification RFIs

Originated by: Supplier or subcontractor
Resolved by: Materials engineer or architect

These RFIs address conflicts between specified materials and what's available, acceptable substitutions, or clarifications on material performance requirements. Procurement officers play a key coordination role.

3. Site Condition RFIs

Originated by: Contractor or site personnel
Resolved by: Geotechnical or civil engineer

When actual field conditions differ from what the contract documents show, different soil types, unexpected underground utilities, or changed drainage patterns, a site condition RFI is used to document the discrepancy and request guidance.

4. Schedule and Timeline RFIs

Originated by: Contractor or project scheduler
Resolved by: Planning engineer or owner representative

These address conflicts in construction sequencing, milestone dependencies, or phasing that aren't clearly defined in the contract documents.

5. Regulatory Compliance RFIs

Originated by: Contractor or compliance officer
Resolved by: Legal advisor or compliance consultant

When local code requirements, permit conditions, or regulatory standards create ambiguity about how a design element should be built, a compliance RFI formalizes the question and documents the official answer.


Biggest Challenges in Construction RFI Management

Most construction teams understand what an RFI is. Fewer have a truly functional system for managing them. Here's where things break down.

1. The Real Cost Is Larger Than It Looks

A 2013 Navigant Consulting study analyzed more than 1 million RFIs across 1,362 global projects. The findings were striking: the average individual RFI costs $1,080 to process, and the cumulative project-level cost averaged $859,000. Nearly one in four RFIs received no reply at all, creating conditions for defective work, unsafe structures, and significant legal exposure.

Those numbers have only grown with inflation and increasing project complexity.

2. Manual Tracking Systems Don't Scale

When RFIs are managed through email threads, shared Excel logs, and PDF attachments, visibility disappears as volume increases. There's no clear accountability, no automated follow-up, no version control, and no reliable audit trail. This approach works on small projects. It fails on complex ones.

3. Slow Response Times Cascade Through the Schedule

The Navigant study found that average RFI response times range from 6.4 to 10 days depending on project size, region, and discipline. A design clarification sitting unanswered for 10 days can delay procurement, stall trade sequencing, and push milestone dates, compounding costs across multiple workstreams.

4. Too Many RFIs Signal a Deeper Problem

High RFI volume is often a symptom, not just a challenge. When a project generates an unusually large number of RFIs, it typically points to:

  • Incomplete bid packages and scope documents

  • Weak preconstruction coordination across disciplines

  • Design quality issues (architectural, structural, and MEP documents not fully coordinated)

  • Poor document control practices

Addressing only the RFI workflow without fixing the upstream cause is like mopping the floor while the pipe is still leaking.

5. Unjustifiable RFIs Add Unnecessary Burden

The Navigant study found that more than one in ten RFIs were unjustifiable, meaning the information was already available in the contract documents, or the question fell outside the appropriate use of the RFI process. These unjustified requests averaged $113,400 in unnecessary costs per project.

6. RFIs Are Sometimes Weaponized, and Courts Have Noticed

Some contractors have attempted to use a high volume of RFIs as litigation evidence of defective plans. Courts have generally rejected this approach, ruling that a large quantity of RFIs does not, on its own, demonstrate plan deficiencies. If you're building a legal case around RFIs, you'll need detailed impact documentation, not just volume.


Best Practices to Improve Your RFI Process

Standardize Before You Start

Establish your RFI process before the project kicks off. Define:

  • What constitutes a valid RFI (and what doesn't)

  • Required documentation at submission

  • Routing and approval paths

  • Expected response timeframes by discipline

  • How RFIs connect to the change order process

Communicate these expectations to every stakeholder at project kickoff, not when the first RFI is already sitting unanswered.

Front-Load Clarity in Preconstruction

The best RFIs are the ones that never need to be written. Strong preconstruction planning, thorough bid leveling, complete scope documents, early cross-discipline coordination, and rigorous document review, reduces RFI volume during construction. Investing an extra week in preconstruction can save months of field disruptions.

Prioritize Ruthlessly

Not every open RFI carries the same urgency. Establish a clear priority system (high / medium / low) tied to schedule impact. Mark high-priority RFIs clearly, but use that designation carefully. If everything is urgent, nothing is.

Group Related Requests

When you notice that a particular discipline or drawing set is generating repeated questions, group related RFIs together. Submitting 12 separate RFIs on the same MEP coordination issue is less effective than one well-organized request that addresses the pattern.

Set Realistic Response Expectations and Hold to Them

Many current contracts specify maximum response times by recipient type (e.g., "engineer has seven business days to respond"). Know your contract. If a response time isn't specified, negotiate one. And if an RFI goes overdue, follow up through your workflow system, not just email.

Don't Use RFIs as a Replacement for Communication

RFIs are formal records, not chat messages. They should document issues that require an official answer and a paper trail. For coordination questions that can be resolved in a phone call or site meeting, use those channels and save the RFI for the formal resolution if needed.

Centralize Everything

Avoid fragmented RFI management across emails, shared drives, and individual spreadsheets. Centralized systems ensure every stakeholder has access to current information, every response is documented, and nothing falls through the cracks.


How AI Is Changing Construction RFI Management

Traditional RFI systems are reactive. They process issues after they've already surfaced. AI-powered workflow platforms introduce something more valuable: proactive information control.

What AI Can Do for Your RFI Workflow

Before bidding:

  • Scan bid packages for scope gaps and missing documentation

  • Flag conflicting specifications across disciplines automatically

  • Identify patterns in historical RFI data that predict risk areas

During preconstruction:

  • Review drawings for coordination conflicts before they reach the field

  • Prioritize potential issues by likely cost and schedule impact

  • Reduce the number of RFIs that need to be written in the first place

During construction:

  • Automate RFI numbering, logging, and status tracking

  • Send deadline alerts and escalation notifications

  • Surface related historical RFIs and design decisions instantly

  • Improve document searchability across large, complex drawing sets

The Strategic Advantage

The most significant benefit of AI in RFI management isn't speed. It's prevention. Firms using AI-assisted workflow platforms don't just process RFIs faster, they generate fewer of them. That translates to:

  • Better bid accuracy

  • Faster procurement cycles

  • Fewer change orders

  • Lower rework costs

  • Stronger margin protection

  • More predictable project outcomes

This is where modern construction workflow platforms pull ahead of legacy approaches. Tools that integrate AI-powered scope analysis, document review, and automated RFI workflows give contractors a structural advantage in project delivery, particularly on complex, fast-track, or multi-discipline projects where information gaps are most costly.


RFI Software vs. Spreadsheets and Email

Many smaller firms still manage RFIs through Excel logs and email chains. This approach has some merit at low volume, it's familiar, flexible, and low-cost to set up. But it breaks down quickly as project complexity increases.

Where Manual Systems Fall Short

Manual systems often create limited visibility across stakeholders, offer no automated deadline alerts, introduce error-prone version control, require manual audit trails, fragment photo and drawing attachments, rely on manual analytics, lack AI-powered risk detection, and provide poor mobile field access.

Modern workflow platforms, by contrast, offer real-time centralized visibility, built-in deadline alerts, automatic version control, comprehensive audit trails, integrated attachments, automated reporting, AI-powered risk detection, and native mobile accessibility.

The real cost of manual RFI management isn't the time spent on tracking. It's the decisions made without accurate information because the right response was buried in an email thread or the wrong version of the log.

What to Look for in RFI Management Software

When evaluating construction workflow software, prioritize:

  • Centralized, real-time RFI dashboard with status tracking

  • Automated routing and deadline notifications

  • Mobile-first field access for photo and document attachment

  • Integration with drawings, specifications, and submittals

  • AI-assisted scope gap detection and document review

  • Change order integration

  • Comprehensive audit trail and reporting


Reducing RFI Volume: Prevention Over Reaction

The most effective RFI strategy isn't a faster processing workflow. It's a system that stops unnecessary RFIs from being created in the first place.

High-performing construction firms consistently outperform on this metric by investing in:

Stronger bid packages- Complete, well-coordinated bid documents reduce downstream ambiguity. Every hour spent on bid package quality at the preconstruction stage saves multiples in field disruption.

Earlier cross-discipline coordination- Most design conflict RFIs stem from architectural, structural, and MEP documents that weren't fully coordinated before bid release. Early-stage multi-discipline reviews catch these conflicts when they're cheap to fix.

Proactive subcontractor scope reviews- Leveling subcontractor scope carefully, before award, surfaces gaps that would otherwise generate a stream of RFIs during construction.

AI-assisted specification analysis- Modern platforms can scan specification sets for internal conflicts, missing sections, and scope ambiguities faster and more reliably than manual review.

Centralized document control- A single source of truth for all project documents ensures that the team is always working from current information, eliminating a significant category of avoidable RFIs.


The Future of Construction RFI Management

RFI management is evolving from a reactive administrative function into a core component of predictive project operations. The firms winning on margin and schedule performance aren't just processing RFIs faster, they're using data from their RFI history to improve how they plan, bid, and coordinate future projects.

Emerging capabilities shaping this shift include:

  • AI-assisted document review at bid and preconstruction stages

  • Predictive scope gap analysis based on project type, size, and design completeness

  • Real-time cross-discipline coordination platforms that reduce conflicts before they reach the field

  • Integrated procurement controls that connect RFI resolutions directly to purchasing workflows

  • Risk forecasting based on historical RFI patterns and project data

The firms that invest in these capabilities now will have a structural advantage in project delivery as the industry continues to grow in complexity.


Final Takeaway

Construction RFI management is one of the most consequential control systems in modern project delivery. When handled strategically, it protects margins, prevents delays, improves design coordination, and creates the documentation foundation that protects your firm if disputes arise.

When handled reactively, through email chains and spreadsheets, with no standardized process, it becomes one of the most reliable sources of cost overruns, schedule slippage, and stakeholder friction on a project.

The good news: the gap between reactive and strategic RFI management is closeable. It starts with standardized processes and strong preconstruction planning, and it accelerates significantly when you add AI-powered workflow tools that help you identify problems before they become expensive questions.

In an industry where unclear information can cost millions, strong RFI workflows aren't a competitive differentiator. They're a baseline requirement for sustainable project performance.

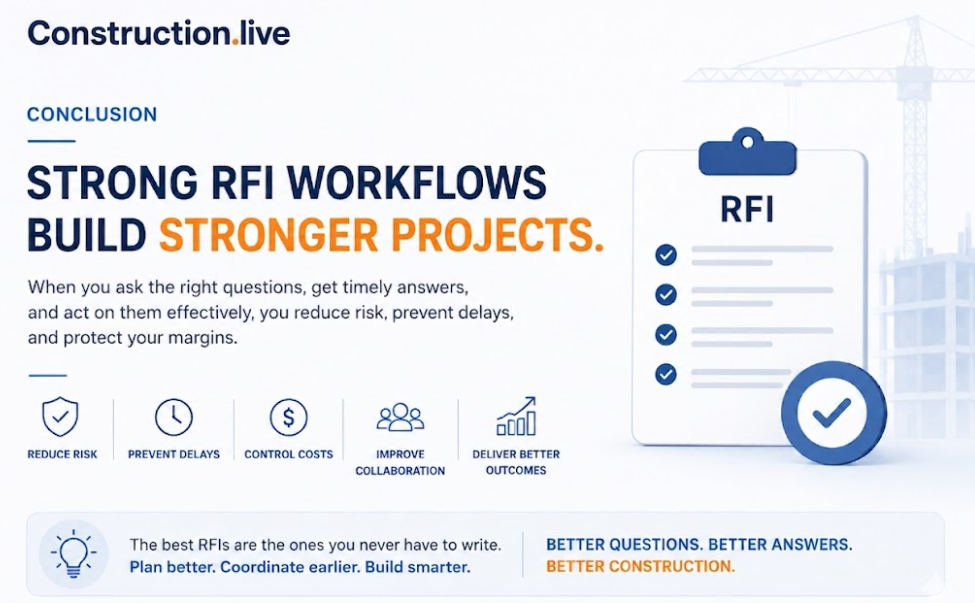

Summary of strong RFI workflows in construction showing benefits like reduced risk, prevented delays, controlled costs, improved collaboration, and better project outcomes.
