construction.live Article
The Preconstruction Process: Complete Guide to Construction Planning, Bid Leveling & Scope Control
Before a single piece of equipment reaches the job site, the preconstruction process is already deciding whether your project succeeds or struggles. This pillar guide walks through every critical stage, from preconstruction planning and bid leveling to scope gap detection and workflow coordination, with actionable strategies, templates, and a full preconstruction checklist.
Most construction projects do not fail on-site. They fail in the conference room, weeks or months before the first crew arrives. The preconstruction process is where budgets either get built on solid ground or quietly set up to collapse under the weight of scope gaps, bid errors, and planning assumptions that were never stress-tested.
Yet despite the industry spending billions on project management software and estimating platforms, the core problems in preconstruction remain stubbornly familiar. Spreadsheets that break under pressure. Bid comparisons that compare different things. Scope documents that leave room for expensive interpretation. Teams that are technically capable but operationally disconnected from one another.
This guide is designed to change that. Whether you are a general contractor trying to tighten your estimating process, a project manager looking to reduce change orders, or a firm owner who wants better visibility into planning quality before execution begins, you will find practical strategies, real-world context, and actionable frameworks throughout.
What Is the Preconstruction Process?
The preconstruction process is everything that happens before physical construction begins. It is the strategic, operational, and technical groundwork that determines how well a project will run once execution starts.
This phase covers a wide range of activities: evaluating whether a project is feasible in the first place, defining what exactly needs to be built, figuring out what it will cost and how long it will take, identifying who should do the work, and making sure all the key stakeholders are aligned before contracts are signed.
When preconstruction is handled well, it creates a shared foundation of clarity. Budgets are realistic. Scopes are defined. Subcontractors know what they are pricing. Risks have been identified and accounted for. The team goes into execution with confidence rather than guesswork.
When preconstruction breaks down, those cracks show up downstream. Change orders start appearing. Costs overrun early estimates. Subcontractors claim they were not responsible for certain scope. Schedules slip. Disputes follow. All of it traces back to decisions, or the lack of them, made during the planning phase.
Who Is Involved in Preconstruction?
The preconstruction process is not a single-department function. It typically involves collaboration across:
• General contractors managing the overall planning and bid process
• Estimators building out cost models and quantity takeoffs
• Project managers coordinating timelines and stakeholder communication
• Owners setting budget expectations and approving major decisions
• Architects and engineers providing design documentation and clarifications
• Subcontractors submitting bids and clarifying their scope of work
The challenge is getting all of these parties aligned around a common understanding of scope, cost, and schedule before anyone starts spending money on labor and materials.
Why Preconstruction Planning Failures Are So Expensive
There is a well-established principle in construction: the cost to fix a problem grows exponentially the later it is caught. A scope gap identified during preconstruction planning might cost a few hours of coordination to resolve. The same gap discovered mid-construction could mean weeks of rework, legal disputes, and budget overruns that dwarf the original estimate.
Construction planning failures tend to cluster around a handful of recurring patterns. Understanding them is the first step to preventing them.
Unrealistic Budgets Built on Incomplete Information
Early-stage cost estimates are often based on limited design documentation. That is unavoidable. But many firms treat preliminary numbers as if they were guaranteed, presenting them to owners without adequate contingency or flagging the assumptions behind them. When detailed pricing comes back higher, the project is already committed and walking it back becomes politically and commercially difficult.
Scope That Sounds Complete But Is Not
Scope documents frequently contain language that sounds specific but leaves room for interpretation. Phrases like "all required finishes" or "per industry standard" create ambiguity that different parties read differently. When bids come in, each subcontractor interprets unclear language based on what benefits them. The gaps only become visible during construction, when someone has to pay for the missing work.
Disconnected Teams Working from Different Assumptions
In many firms, estimators, project managers, and field supervisors operate in relative silos. The estimator builds a cost model based on certain assumptions about how the work will be executed. The project manager schedules around a different set of assumptions. The field team operates according to what actually makes sense on-site. Nobody is wrong exactly, but nobody is aligned either.
Overreliance on Spreadsheets and Manual Systems
Spreadsheets are not inherently bad. They are flexible, familiar, and fast for small tasks. But when the preconstruction workflow depends on complex, multi-tab Excel files that only one or two people fully understand, the risk of formula errors, version confusion, and data loss becomes significant. Spreadsheet-based systems also do not scale well as project complexity increases.
The Key Stages of the Preconstruction Process
Understanding how preconstruction is structured helps teams identify exactly where their systems are working well and where they are losing ground. Most preconstruction processes follow five major stages, each with its own set of risks and best practices.
Stage 1: Project Planning and Feasibility
Every project starts with a question: is this worth pursuing, and if so, what will it take to do it well? The project planning stage answers that question through feasibility analysis, budget forecasting, preliminary schedule development, risk identification, and early stakeholder alignment.
The goal is not to have all the answers at this stage. It is to identify what questions need answering before the project moves forward, and to make sure the team has a realistic sense of what they are taking on.
Common failures at this stage include optimistic budget assumptions that are not stress-tested, weak risk documentation, and stakeholder alignment that exists on paper but not in practice. When a project owner has a fundamentally different expectation about cost or schedule than the contractor, and that misalignment is not surfaced during planning, it creates problems that no amount of execution skill can fully resolve.
Stage 2: Estimating and BOQ Development
Once the project scope is defined clearly enough to price, the estimating process begins. This involves developing a bill of quantities, working through material and labor costs, validating vendor pricing, and producing a budget that the team is prepared to stand behind.
Quantity takeoffs are the foundation of accurate estimating. Errors at this stage, whether from manual counting mistakes, outdated drawings, or incomplete specifications, create cost variances that compound as procurement progresses. Small BOQ inaccuracies on a large project can translate into six-figure budget gaps.
One of the most important habits in good estimating is documenting assumptions explicitly. When a cost is based on a particular material grade, labor productivity rate, or lead time assumption, that needs to be visible so that if conditions change, the estimate can be updated accordingly.
Stage 3: Bid Leveling and Contractor Comparison
Bid leveling is one of the most technically demanding and frequently mishandled stages in the entire preconstruction process. The goal is to compare bids from multiple subcontractors in a way that is actually apples-to-apples, so that the selection decision is based on genuine cost and capability differences rather than scope discrepancies that were never noticed.
In practice, bids almost never come in on perfectly equivalent terms. One subcontractor includes temporary power. Another excludes it. One prices a specific brand of equipment. Another uses a generic substitute. One has a detailed payment schedule. Another has vague language that could lead to disputes later.
Bid leveling involves systematically adjusting for all of these differences so that decision-makers can see a normalized comparison. It also involves reviewing qualifications, past performance, financial stability, and other non-price factors that affect whether a contractor can actually deliver what they have quoted.
The consequences of skipping or rushing bid leveling are significant. Selecting the lowest bid without understanding what it includes and excludes is one of the most reliable ways to generate change orders and cost overruns on a construction project.
Stage 4: Scope Review and Gap Detection
Scope gaps are the silent budget killers of construction. They exist in the space between what each subcontractor believes they are responsible for and what the project actually requires. Some of the most expensive gaps are not the result of anyone acting in bad faith. They are simply the product of ambiguous documentation that different parties read differently.
A systematic scope review process involves going through each subcontractor's bid in detail, comparing their stated inclusions and exclusions against the overall project requirements, and flagging anywhere that something required by the project is not clearly included in anyone's scope.
This process is time-consuming when done manually, but it is one of the highest-value activities in preconstruction planning. Every hour spent identifying scope gaps before contracts are signed prevents many hours of dispute and rework later.
Stage 5: Workflow Coordination and Process Management
The final major stage of preconstruction is about making sure all the operational machinery is working. This means ensuring that documents are organized and accessible, that communication between stakeholders is clear and consistent, that approvals happen in a timely way, and that the information generated during preconstruction is handed off to the execution team in a useful format.
Preconstruction workflow failures at this stage often look like email chains that are difficult to track, versions of documents that are out of sync, approvals that get stuck because the right person is not looped in, and planning information that exists somewhere but is not easy to find when needed.
Firms that invest in standardized preconstruction workflow systems, whether through dedicated software or well-designed internal processes, consistently report better outcomes in terms of planning speed, accuracy, and team alignment.

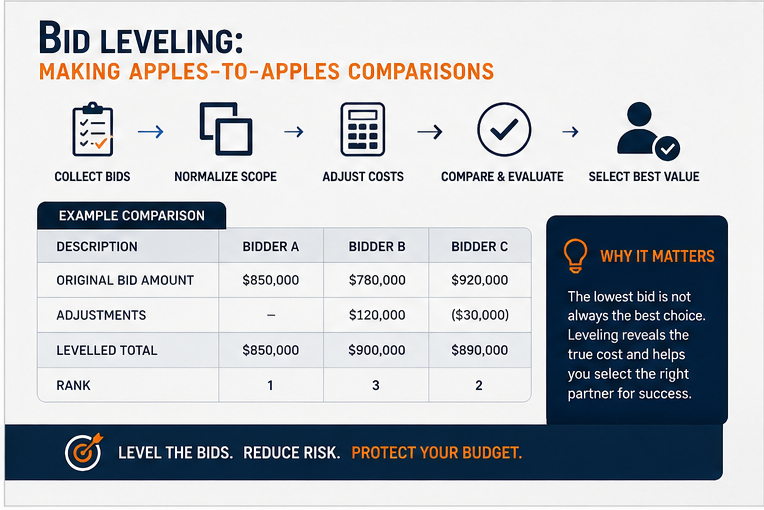

Bid Leveling: A Closer Look at What It Requires
Because bid leveling is so frequently cited as a source of problems in preconstruction, it deserves more detailed attention. The core challenge is that bid leveling requires both technical rigor and clear process, and most firms do not have a standardized system for doing it consistently.
The Structural Problem with Most Bid Comparisons
When bids come in, the instinct is to line up the bottom-line numbers and rank them. This is understandable given time pressure and the volume of information involved. But it creates a fundamentally flawed comparison, because the bottom-line numbers are measuring different things.
Subcontractor A prices a complete scope at $850,000. Subcontractor B prices a slightly narrower scope at $780,000. On a simple comparison, B looks cheaper. After leveling, it turns out that B's exclusions add $120,000 in additional costs that will need to be covered elsewhere. The actual cost comparison is $850,000 versus $900,000, which completely changes the decision.
This kind of error is not unusual. It is common. And it is one of the primary reasons why projects that look well-budgeted during preconstruction end up with cost growth during execution.
What a Good Bid Leveling Process Includes
A rigorous bid leveling process covers several distinct elements:
• Scope normalization: aligning all bids against a master scope document so that inclusions and exclusions are evaluated consistently
• Cost adjustment: adding or removing costs from each bid to reflect scope differences, so that the adjusted totals represent equivalent work
• Clarification tracking: documenting all questions sent to and answers received from each bidder, and incorporating those answers into the analysis
• Qualification review: assessing each contractor's licensing, insurance, financial stability, and track record alongside their price
• Risk assessment: identifying which bids carry higher execution risk based on their terms, assumptions, or contractor history
Running this process consistently, across all projects and all team members, requires standardized templates and a clear workflow. Without those, the quality of bid leveling varies depending on who is doing it, which is its own form of organizational risk.
Understanding Scope Gaps and How to Prevent Them
Scope gaps are worth a dedicated section because they cause a disproportionate share of construction project cost overruns. And unlike some project risks that are genuinely difficult to foresee, scope gaps are largely preventable with the right preconstruction planning discipline.
Where Scope Gaps Come From
Scope gaps typically originate in one of three places. The first is incomplete design documentation, where drawings or specifications simply do not address certain elements of the work. The second is ambiguous language in scope documents, where the description is broad enough that different parties interpret it differently. The third is coordination gaps between trades, where work that sits at the boundary of two subcontractors' scopes ends up in neither one's bid.
That third category is particularly common and particularly expensive. Electrical connections to mechanical equipment. Sleeves for plumbing penetrations through concrete. Temporary protection for finished surfaces during subsequent trades. These coordination items fall through the cracks between trade scopes all the time, and each one is a potential change order.
A Systematic Approach to Scope Gap Detection
The most effective approach to scope gap detection is to work from a master project scope document and trace every requirement through to at least one subcontractor's confirmed inclusion. Any requirement that cannot be traced to a confirmed inclusion is a gap that needs to be resolved before contracts are signed.
This sounds straightforward, but executing it well requires a structured process, a clear document management system, and enough time to do it properly. Many firms cut corners here because of schedule pressure, accepting that some gaps will be discovered during construction. That is a false economy. The time saved in preconstruction is paid back many times over in change order negotiations and rework.
Preconstruction Workflow: Building Systems That Scale
A well-designed preconstruction workflow is what turns individual competence into organizational capability. The goal is to create systems that produce consistent, high-quality outcomes regardless of which team member is running the process.
The Problem with Ad Hoc Workflows
Many firms rely on the expertise and habits of individual estimators and project managers rather than on documented, standardized processes. This works reasonably well when those individuals are available and experienced. It breaks down when someone is unavailable, when the team grows, or when a project is more complex than usual.
Ad hoc workflows also make it extremely difficult to identify where problems are coming from. When something goes wrong on a project, is it because the bid leveling process was flawed, or because the scope review was incomplete, or because the estimate was based on outdated pricing? Without documented processes, these questions are hard to answer and even harder to fix systematically.
Components of an Effective Preconstruction Workflow
A mature preconstruction workflow typically includes several key components:
• Standardized templates for each stage of the process, from initial feasibility through final bid analysis
• Clear role definitions specifying who is responsible for each task and at what stage
• Document management systems that ensure everyone is working from the current version of relevant documents
• Review and approval checkpoints that ensure quality at each major stage before the process moves forward
• Communication protocols that keep stakeholders informed without creating information overload
• Handoff documentation that transfers the key information generated during preconstruction to the execution team in a useful format
The specific tools used to implement these components matter less than the discipline of having them and using them consistently. Some firms use dedicated construction software. Others use well-structured combinations of general-purpose tools. What distinguishes high performers is not the sophistication of their tools but the consistency of their processes.
Technology and AI in the Preconstruction Process
The construction industry has seen significant technology investment over the past decade, and preconstruction is one of the areas where that investment has had the most impact. Understanding what technology can and cannot do for preconstruction is important for making smart decisions about adoption.
Where Technology Genuinely Helps
The most significant technology benefits in preconstruction tend to cluster around activities that involve large volumes of data or require consistent application of rules and standards. Quantity takeoff software that reads digital drawings directly reduces manual counting errors and speeds up the estimating process significantly. Bid management platforms that standardize how bids are collected and compared reduce the scope normalization workload. Workflow automation tools that route documents for review and approval cut down on the email chains that slow preconstruction down.
AI-assisted tools are increasingly being used for pattern recognition in bid analysis, identifying unusual scope language, flagging potential scope gaps, and benchmarking costs against historical data. These capabilities can genuinely improve the speed and quality of preconstruction analysis when they are well implemented.
What Technology Cannot Replace
Technology works best when it amplifies the judgment of experienced professionals rather than replacing it. An AI tool that flags potential scope gaps still requires a knowledgeable estimator to evaluate whether the flag is significant and how to resolve it. A bid comparison platform that normalizes costs still requires someone who understands construction scope to design the normalization framework correctly.
Firms that adopt technology expecting it to solve process problems without addressing the underlying process design tend to be disappointed. Technology makes good processes faster and more consistent. It cannot make a bad process good.

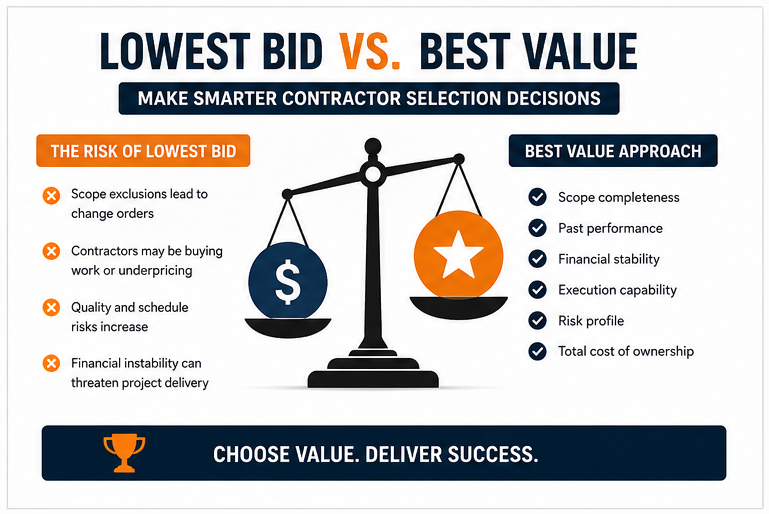

Lowest Bid vs. Best Value: Making Smarter Contractor Selection Decisions
One of the most important judgment calls in preconstruction is deciding which subcontractor to select when multiple bids are available. The default instinct, selecting the lowest price, is understandable but often leads to poor outcomes.
Why the Lowest Bid Is Often Not the Best Choice
The lowest bid is sometimes the lowest because the subcontractor excluded something. Sometimes it is lowest because they are buying work to fill capacity and will struggle to maintain margins. Sometimes it is lowest because their cost model is simply wrong, and they will either look for change orders to recover or fail to deliver what was promised.
Each of these scenarios creates problems downstream. Scope exclusions become change orders. Contractors buying work often cut corners on quality. Contractors with wrong cost models become financially stressed mid-project, which creates schedule and quality risks for everyone.
A Better Framework for Contractor Selection
A best-value approach to contractor selection evaluates multiple factors alongside price:
• Scope completeness: does the bid include everything the project requires, with clear documentation of any exclusions?
• Past performance: does this contractor have a track record of delivering on-time, on-budget, and to the required quality standard?
• Financial stability: is this contractor financially capable of sustaining the project through to completion?
• Execution capability: do they have the workforce, equipment, and management capacity to handle this project at this time?
• Risk profile: are there terms in their bid or their history that suggest elevated execution risk?
This kind of multi-factor evaluation takes more time than a simple price ranking. But it consistently produces better project outcomes, particularly on complex projects where subcontractor performance has a significant impact on overall schedule and quality.
Preconstruction Best Practices for Modern Construction Teams
The firms that consistently produce strong preconstruction outcomes share a set of habits and disciplines that are worth studying. None of them involve particularly exotic technology or uncommon talent. They involve doing the fundamentals well, consistently, on every project.
Standardize Across the Team, Not Just Within It
The goal of standardization is not to eliminate individual judgment. It is to create a shared baseline that everyone operates from, so that the quality of the preconstruction process does not depend entirely on which team member is running it. Standard templates for bid leveling, scope review, and risk assessment create that baseline.
Invest in Scope Clarity Early
Every hour spent clarifying scope before bids are solicited saves multiple hours of clarification and dispute after bids come in. This means working with architects and engineers to resolve ambiguities in design documents before issuing them, writing scope documents that explicitly address coordination items between trades, and requiring bidders to confirm their understanding of scope in writing.
Build in Time for Real Review
One of the most common preconstruction planning failures is not having enough time allocated for actual review. Bid leveling and scope gap detection done under extreme time pressure produce worse outcomes than the same processes given adequate time. Building realistic review windows into the preconstruction schedule is not a luxury. It is a risk management decision.
Treat Preconstruction Information as a Project Asset
The estimates, bid analyses, scope reviews, and risk assessments produced during preconstruction contain valuable information that should inform execution decisions. Treating this information as a living project asset, accessible to the execution team and updated as conditions change, creates continuity that reduces the knowledge gaps that often occur at the planning-to-execution handoff.
Measure and Improve
The best preconstruction teams actively track how their preconstruction estimates compare to final project costs, and use that data to improve their estimating and planning processes. This kind of feedback loop is how organizations build the institutional knowledge that differentiates experienced firms from less experienced ones.
Preconstruction Checklist: What to Confirm Before Execution Begins
A structured preconstruction checklist is one of the simplest and most effective tools a construction firm can implement. It provides a consistent quality gate that ensures the key elements of preconstruction have been completed before the project transitions to execution.
The following checklist is designed for use at the transition point between preconstruction and execution. It is not exhaustive, but it covers the most important categories.
Project Planning and Feasibility
• Budget has been validated against current market pricing and is based on well-documented assumptions
• Key project risks have been identified and mitigation strategies are in place
• Stakeholders are aligned on budget, schedule, and scope, and that alignment is documented
• Preliminary schedule has been reviewed and resource requirements have been validated
• Any value engineering decisions have been documented and approved
Estimating and BOQ
• Quantity takeoffs have been completed and independently reviewed
• Bill of quantities is final and reflects current design documentation
• All cost assumptions are documented and accessible
• Vendor and subcontractor pricing is current and has been confirmed in writing where appropriate
• Contingency allocations are appropriate for the stage of design and project risk profile
Bid Management
• All bids have been leveled using a standardized process
• Scope has been normalized across all bidders
• Clarification responses from bidders have been documented and incorporated into the analysis
• Contractor qualifications have been reviewed and confirmed
• Selection decisions are documented with clear rationale
Scope Control
• All scope gaps have been identified and assigned to a specific party
• Subcontractor exclusions have been reviewed and either accepted or addressed
• Coordination scope between trades has been reviewed and documented
• All scope assumptions are confirmed with the owner and design team
Workflow and Documentation
• All preconstruction documents are organized in a central, accessible location
• Processes for document control and version management are in place
• The execution team has been briefed on the preconstruction findings and assumptions
• Communication protocols for the execution phase have been established
Final Thoughts: Preconstruction Is Where Profit Is Protected
The preconstruction process does not generate revenue directly. It does not produce visible output the way site work does. That makes it easy to underinvest in, especially when schedule pressure or workload makes it tempting to rush through planning and get to execution.
But the math is straightforward. Projects that go through a rigorous preconstruction process have better budget accuracy, fewer change orders, more effective subcontractor relationships, and higher margins. Projects that rush preconstruction carry that exposure into execution and spend months managing the consequences.
Building a strong preconstruction capability requires investment in people, processes, and tools. It requires leadership that values planning discipline as much as execution speed. And it requires a culture where the time taken to do preconstruction well is understood as time that pays for itself many times over.
The firms that consistently win in modern construction are not always the most aggressive or the most resourced. They are often the most disciplined in how they plan. That discipline starts with a rigorous, well-structured preconstruction process, and it pays dividends from the first day of execution through to final closeout.
