construction.live Article
Why Contractors Lose Money on Approved Change Orders (And How to Protect Your Profit)
Many contractors assume an approved change order guarantees profit, but hidden costs, undocumented labor, delayed billing, and weak tracking often erode margins. Learn the most common causes of revenue leakage and the change order management practices that protect profitability from identification through payment.
Most contractors assume that once a change order is approved, the financial risk is over. The work is documented. The customer agreed to pay. The project moves forward.
But approved change orders are where many small general contractors and subcontractors quietly lose money every year. The root cause is almost never the approval itself. It is weak construction change order management: the systems, habits, and documentation practices that govern what happens before and after the approval is signed.
Work starts before costs are tracked. Labor hours go undocumented. Indirect expenses accumulate without anyone logging them. By the time payment arrives, the margin is already gone.
Why do contractors lose money on approved change orders?
Contractors lose money on approved change orders because labor hours are underreported, indirect costs are missed, markups fail to cover overhead, and billing delays create financing costs. Approval confirms the work can be billed, but it does not guarantee all project costs have been captured.
This guide covers each of these failures and lays out a change order process that protects margin from identification through final payment.
What the Data Shows
The scale of the problem is well documented.
HKA's 2025 CRUX Insight Report, analyzing more than 2,200 projects across 114 countries, found that change in scope is the number one cause of construction disputes globally, affecting over 28% of disputed projects. Disputed costs averaged 33.4% of original contract budgets. In North America, scope-related disputes surged 40% in 2024 to an average of $60.1 million, with an average resolution time of 12.5 months.
Navigant Construction Forum research across 1,362 projects found that change order costs typically represent 10 to 15% of total contract value. On a $2 million project, that is $200,000 to $300,000 in additional scope that has to be documented, priced, billed, and collected to protect margins.
Rabbet's 2024 Construction Payments Report found that 82% of contractors experience payment waits over 30 days, with slow payments costing the industry an estimated $280 billion in 2024.
The process failures behind these numbers are identical on a $500,000 job as on a $500 million one.
5 Reasons Contractors Lose Money on Approved Change Orders
Most profit loss on change orders does not happen at the negotiating table. It happens at the job site, in the day-to-day work, and in the gap between when work is performed and when it is documented.
Work Starts Before Pricing Is Finalized
When an owner, architect, or GC requests additional work, the default instinct is to keep the project moving and sort out the paperwork later. Work is performed, labor and materials accumulate, and pricing is calculated after the fact from memory rather than actual records. The final change order value is almost always lower than what the work actually cost.
Labor Hours Are Estimated, Not Tracked
Labor is typically the largest cost component of a change order and the one most likely to be underreported. Field teams focus on completing work. When a foreman reconstructs labor time a week later, they capture what they remember, not what happened. An eight-hour discrepancy per week across a four-week scope change compounds quickly on projects with multiple concurrent changes.
Indirect and Consequential Costs Are Ignored
Most contractors price change orders around direct labor and materials. The costs that do not make the estimate often erode margin the most: additional supervision time, equipment downtime, crew scheduling disruptions, material handling, and productivity loss on base contract work. These are the primary areas where contractor recovery falls short, not the direct cost line items.
Standard Markups Do Not Cover Actual Overhead
Most contracts allow a 10 to 15% markup on change orders. But electrical contractors alone face average overhead rates exceeding 19%. For many specialty contractors, that standard markup does not recover actual overhead costs, let alone generate the target margin. Accepting standard markup language without reviewing it against actual overhead rates guarantees below-market returns on every change order.
Approval Does Not Mean Immediate Payment
A 30-day or longer wait on an approved change order means the contractor finances the work from the moment it starts. According to Rabbet's 2024 data, 82% of contractors face payment waits over 30 days, with the average subcontractor waiting 56 days after submitting a pay application. That financing cost is a real, often uncalculated expense tied directly to the change order approval process timeline.

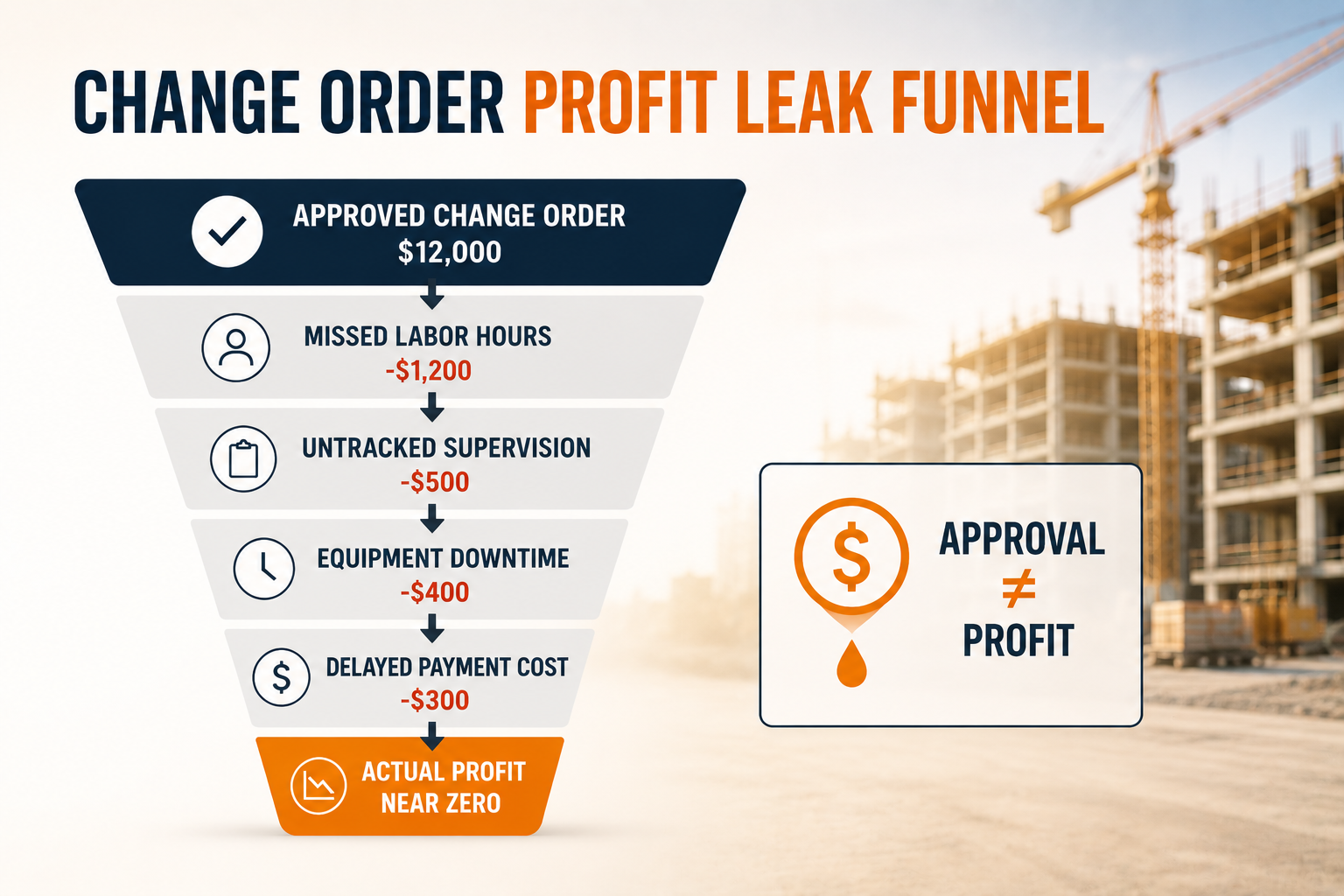

A Typical Change Order Profit Leak: A Real Scenario
A subcontractor receives approval for a $12,000 change order. The crew spends two weeks completing the work. Four additional labor days are never recorded because the foreman reconstructs the time at the end of the billing cycle rather than logging it daily. Equipment downtime during the scope change is not included in the pricing because it was not tracked separately from base contract work. Coordination calls with the GC, supervision time, and material restocking are not itemized.
The change order is approved and eventually paid in full.
On paper, the contractor recovered $12,000. In reality, the actual cost was closer to $14,500. The change order was approved. The project still lost money on it.
This is not a controversial story. No one rejected the work. The owner paid what was submitted. The loss came entirely from inside the contractor's own change order tracking process.
Managing change orders in construction means closing that internal gap, not just winning the approval.
What Poor Change Order Management Actually Costs
The financial consequences extend beyond the individual order that gets underpriced.
When labor, materials, and indirect costs are not fully captured, the approved amount does not reflect actual cost. With net profit margins averaging 6.3% of revenue across the construction industry according to the CFMA 2024 Financial Benchmarker, there is no room to absorb that loss consistently.
Every change order not submitted promptly also extends the period during which the contractor is financing the work. Billd's 2025 research found that subcontractors who accounted for working capital costs in their change orders earned a 24% profit margin, compared to 17% for those who did not. Cash tied up in underbilled or disputed changes is unavailable for hiring, equipment, or new project pursuit. A dispute that takes 12 months to resolve converts an approved change order into a long-term financing obligation.
Why Small Contractors Carry the Most Risk
Large construction firms have dedicated project controls, change order administrators, and accounting staff. Small contractors do not.
The owner manages estimating, operations, project management, client relationships, and billing at the same time. When a project gets busy, documentation becomes the lowest priority. That is when change order costs go untracked.
The most common documentation failure in construction change order management is relying on recollection. A superintendent remembers extra work occurred. A foreman recalls the crew spent more time on a task. Memory is not documentation. It rarely holds up in a payment dispute.
Most small contractors also manage projects across email threads, text messages, and photos on personal phones. When change order information is distributed across those channels, gathering supporting evidence at billing time is slow and incomplete.
A Practical Change Order Process That Protects Margin
A good construction change order process does not need to be complicated. It needs to be consistent. Whether you are a general contractor managing multiple subcontractor change orders or a specialty contractor handling your own scope changes, the workflow is the same.
Step 1: Identify and flag the change immediately. As soon as additional work or unforeseen conditions are discovered, treat them as change order events from that moment forward.
Step 2: Document before work progresses. Capture photos, site conditions, crew assignments, labor impacts, and quantities. The documentation created closest to the event is the most defensible. See our construction daily reports guide for how field documentation feeds directly into the change order documentation workflow.
Step 3: Notify the owner or GC early. When stakeholders understand that additional work is occurring and why, the change order approval process moves faster and with less friction. Surprises create disputes.
Step 4: Price from actual data. Use tracked labor hours, materials receipts, equipment logs, and documented overhead rates. Review your actual overhead against the markup percentage in the contract before accepting standard terms.
Step 5: Track through payment, not just approval. Each change order should have a visible status: identified, submitted, approved, billed, paid. Weekly change order tracking prevents approved work from sitting unbilled for weeks.
The Role of Change Order Management Software
A consistent process requires consistent tools. Spreadsheets and email threads are the most common failure points in construction change order management because they are passive. They hold information but do not flag what is overdue or move work forward.
Change order management software solves this by giving each change order a structured, visible status the whole team can see. The strongest systems connect change order tracking directly to construction daily reports, subcontractor management, RFI logs, and construction document management so that documentation, pricing, and approval happen in one place rather than across disconnected inboxes. See how this fits into a broader construction workflow automation strategy in our related guides.
Warning Signs Your Change Order Workflow Is Leaking Revenue
These are the early signals that your change order tracking has gaps:
Change orders are submitted weeks after the work occurs
Labor hours are estimated at billing time rather than tracked in the field
Supporting documentation is difficult to locate when a customer asks for it
Project managers find unreported scope changes during invoice preparation
Approved change orders sit unbilled for more than two weeks
Scope discussions happen verbally with no written follow-up
If two or more of these describe your operation, the process is leaking revenue on every active project.
Frequently Asked Questions
Why do contractors lose money on approved change orders?
The most common causes are undocumented labor hours, untracked indirect costs, delayed billing, and markup rates that do not reflect actual overhead. Approval guarantees the work will be paid for. It does not guarantee all costs were captured.
What is the most common change order documentation mistake?
Waiting to document. The further removed from the actual work, the less accurate the record. Documentation created the same day the work occurs is both more accurate and more defensible in a dispute.
How do change order disputes start?
Most disputes begin with incomplete documentation. When labor hours are estimated rather than tracked and scope boundaries are defined verbally, owners have grounds to question the numbers. Strong change order documentation removes that ambiguity before it becomes a dispute.
What costs do contractors most commonly miss?
Indirect costs: supervision time, scheduling disruptions, productivity loss on adjacent work, and material handling. These rarely appear in estimates unless someone is specifically tracking them in the change order workflow.
How often should change orders be reviewed?
Weekly. A standing review covering status from identification through payment is one of the highest-return habits a small contractor can build.
The Bottom Line
Approved change orders do not automatically protect profit. The loss usually has nothing to do with whether the work gets approved. It comes down to whether costs were tracked, documentation was created on time, and billing happened before carrying costs ate into the margin.
The contractors who protect change order margins document early, track costs separately, notify promptly, and review weekly. Tightening this process is one of the fastest ways to recover margin that is already being earned but not collected.
Written by
Rahul Vaishnav
.
